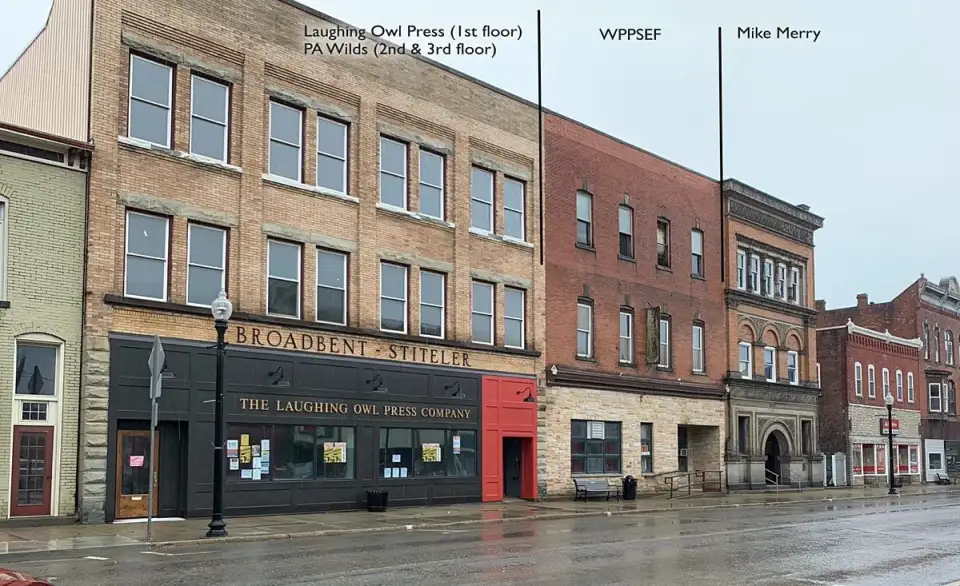

Below the front façade, the existing foundation consists of rough-hewn stones resting on bedrock, while the rear has a newly poured slab. New foundation piers were sunk to increase the floor loading. The basement, which will house the utility entrances and possibly batteries in the future, is outside of the Passive House envelope. The elevator pit that penetrates into the basement will be thoroughly air sealed and wrapped in mineral wool.
To thermally isolate the basement from the rest of the building, mineral wool will be inserted between the ground floor joists with a continuous layer of rigid insulation below that. A self-adhered membrane on top of the subfloor will be the air barrier.
The brick party walls have been repointed and are being coated on the interior in a water-based acrylic air barrier, allowing for an exposed, painted-brick aesthetic on the interior. The party walls will only need insulating in a few places to eliminate potential thermal bridging issues. An air barrier membrane will function as the transition from the walls to the taped sheathing layer in the roof assembly. The rear masonry wall will be insulated from the exterior, most likely with an exterior insulation and finish system.
Three ERVs will be used to separately ventilate each floor of this all-electric building. Although one centralized ERV might have been sufficient, the floors are anticipated to be leased by three different tenants and put to different uses, and separating the ventilation systems eliminates the possibility of cross-contamination—a particularly important benefit in the time of Covid.
Supplemental heating and cooling will be provided by a variable refrigerant flow system. As the demand for hot water will be relatively small, an electric-resistance water heater can meet the requirements without pushing the total energy demand beyond Passive House limits. The group is excited to field a demonstration of how energy efficiency in design can smooth the transition to all-electric buildings. “And in our case, we are saving money,” Moshier points out, “because we would have had to re-establish a gas line to the building.”
In keeping with WPPSEF’s mission, there will be a 43-kW PV array on the rooftop, which should produce enough renewable energy to cover the building’s load on an annual basis. This big contribution from the PV system is allowing the project to get certified using the Primary Energy Renewable criteria.
The building renovation has been proceeding in phases, interrupted at times by pandemic-related shutdowns. Even so, the building shell retrofit work is expected to be completed by late fall. Occupancy should begin by next fall, hopefully in time for an anticipated influx of visitors to Pennsylvania’s wildest region.
